Project views

Besides the task list, a project can be viewed as a dashboard, a board and a timeline. Each is in the project's top bar. The board and timeline show the same task lists and tasks as the List view, and use the same Filters. See Task lists and tasks.

Dashboard

Dashboard summarises the project. It updates as tasks and time logs change.

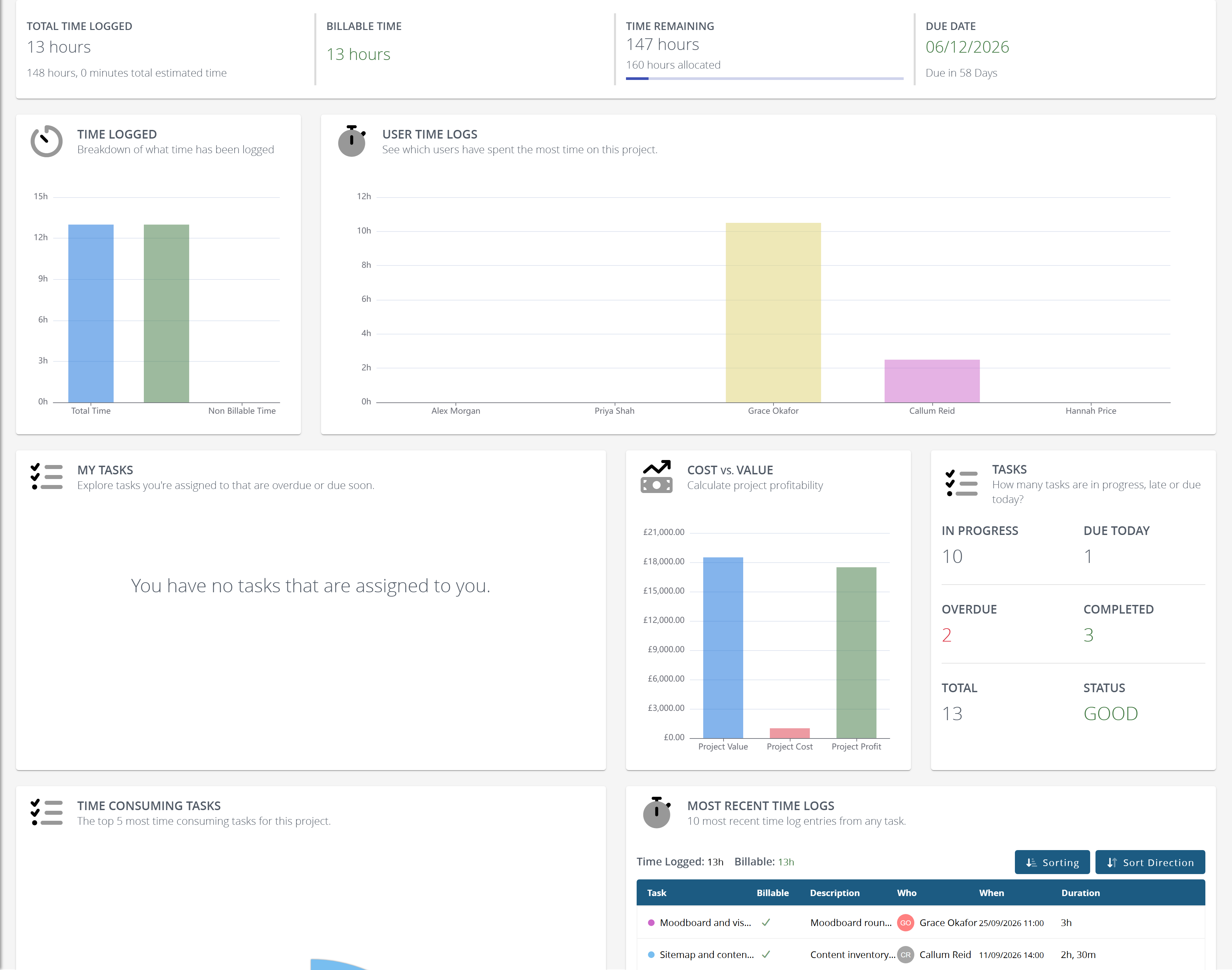

The project dashboard: time totals, time charts, your tasks, cost against value, and task counts

The figures across the top

Figure What it shows
Total Time Logged All the time logged on the project. Below it, the total of the estimates on the project's tasks, or "No time estimated"
Billable Time The billable time logged, in green. Below it, the non-billable time, in red
Time remaining The allocated hours minus the billable time. Non-billable time is not taken off. Below it are the allocated hours and a bar showing how much of the allocation the billable time has used. Hovering over the bar shows the billable time delivered
Due Date The project's due date, in green, or in red once it has passed. Below it, "Due in" a number of days, "Due Today", or "Overdue by" a number of days

When the billable time is more than the allocation, a red warning sign appears next to Time remaining. Hovering over it shows by how much the project has overrun.

The time figures show "-" until time has been logged.

The dashboard sections

Section What it shows
Time Logged A bar chart of the total, billable and non-billable time, in hours
User Time Logs A bar chart of the hours each user on the project has logged
My Tasks Up to five tasks assigned to you that are not complete, with the earliest due date first. Tasks with no due date come last. You can complete them and use their actions here, as in the task list
Cost vs. Value A bar chart of the Project Value, the Project Cost and the Project Profit, which is the value minus the cost
Tasks Counts of tasks In Progress (not complete), Due Today (not complete and due today), Overdue (not complete and due before today) and Completed, the Total, and the project's Status
Time Consuming Tasks The five tasks with the most time logged, as a chart in each task's colour. Hovering over a task shows its total time, and clicking it opens the task
Most recent time logs The ten most recent time logs from any task, with who logged them, the task and when. The tick or cross switches a time log between billable and non-billable

How the cost is worked out

The Project Cost adds up every time log on the project, billable or not. Each time log costs the user's day rate divided by their contracted hours per day, for the length of the time log. A user with no day rate adds nothing to the cost. Day rates and contracted hours are set on each user's Employment tab. See Users.

Status

Status rates the project as Excellent, Good, Average, Poor or Abysmal. It starts at Excellent and drops one step for each of these that is true:

  • there are overdue tasks, and they are a fifth or more of all the tasks
  • there are more tasks in progress than five for each user on the project
  • the tasks due today are more than a tenth of the tasks in progress
  • more than half of the tasks are in progress
  • there is more non-billable time than billable time

Excellent and Good are shown in green, Average in amber, and Poor and Abysmal in red.

Board

Board shows each task list as a column, with its tasks as cards.

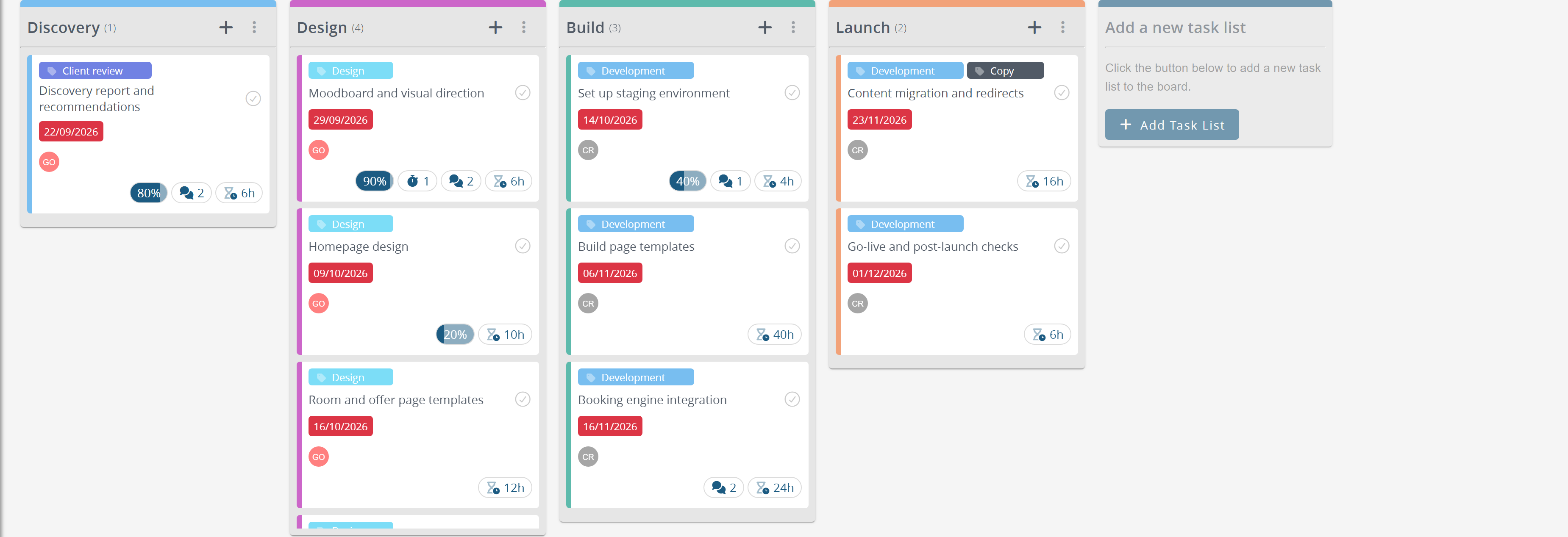

The project board: one column per task list

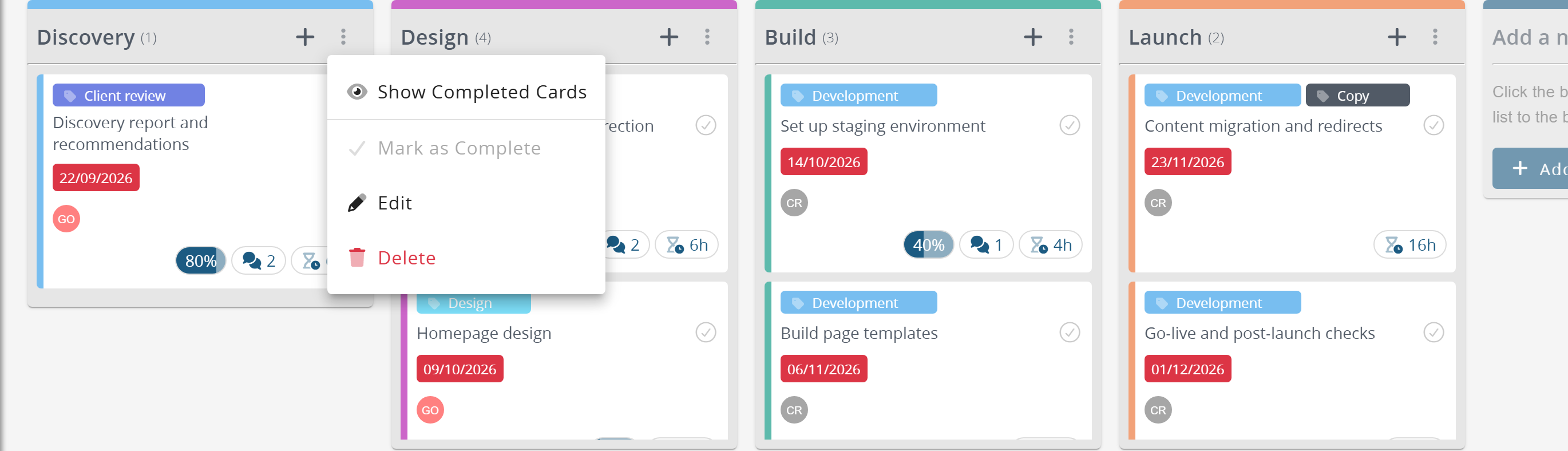

A task list's menu on the board

Each column shows the task list's name and, in brackets, how many open tasks it holds. Its border is the task list's colour.

Column control What it does
+ (Add task) Adds a card at the foot of the column, marked "New Task". Type the task's name and press Enter. If the project's tasks have required properties, Add Task opens the full task form instead
Options Opens the column's menu

The Options menu holds:

Option What it does
Show Completed Cards / Hide Completed Cards Shows or hides the column's completed tasks. Only shown when the column has completed tasks
Mark as Complete Marks the task list as complete, after you confirm. Unavailable while the column has tasks that are not complete
Edit Changes the task list's name, description and colour
Delete Deletes the task list permanently, after you confirm

Each card shows:

  • the task's tags. The cross on a tag removes it
  • its name. Click it to open the task panel
  • the circle that marks it complete. A task with open subtasks shows how many are left instead, and clicking it opens them
  • for a task with subtasks, a progress bar and the number completed, such as "2/5". Click it to open Subtasks, where you can complete and add subtasks
  • its due date, in red. Hovering over it shows how many days until it is due
  • up to three assignees, with "+2" and so on for the rest. Hovering over the count lists them
  • the task's actions: Edit, Delete, Add tag, Progress, Log Time, Comments, Files and Time Estimate. See Task lists and tasks

Completed tasks are not shown unless Show Completed Cards is chosen, or Show Completed Tasks is on in the filters.

Drag a card to reorder it or to move it to another column, which moves the task to that task list. Drag a column to change the order of the task lists.

Add a new task list at the end of the board holds Add Task List, which adds another column.

Timeline

Timeline shows the tasks against a calendar, grouped by task list.

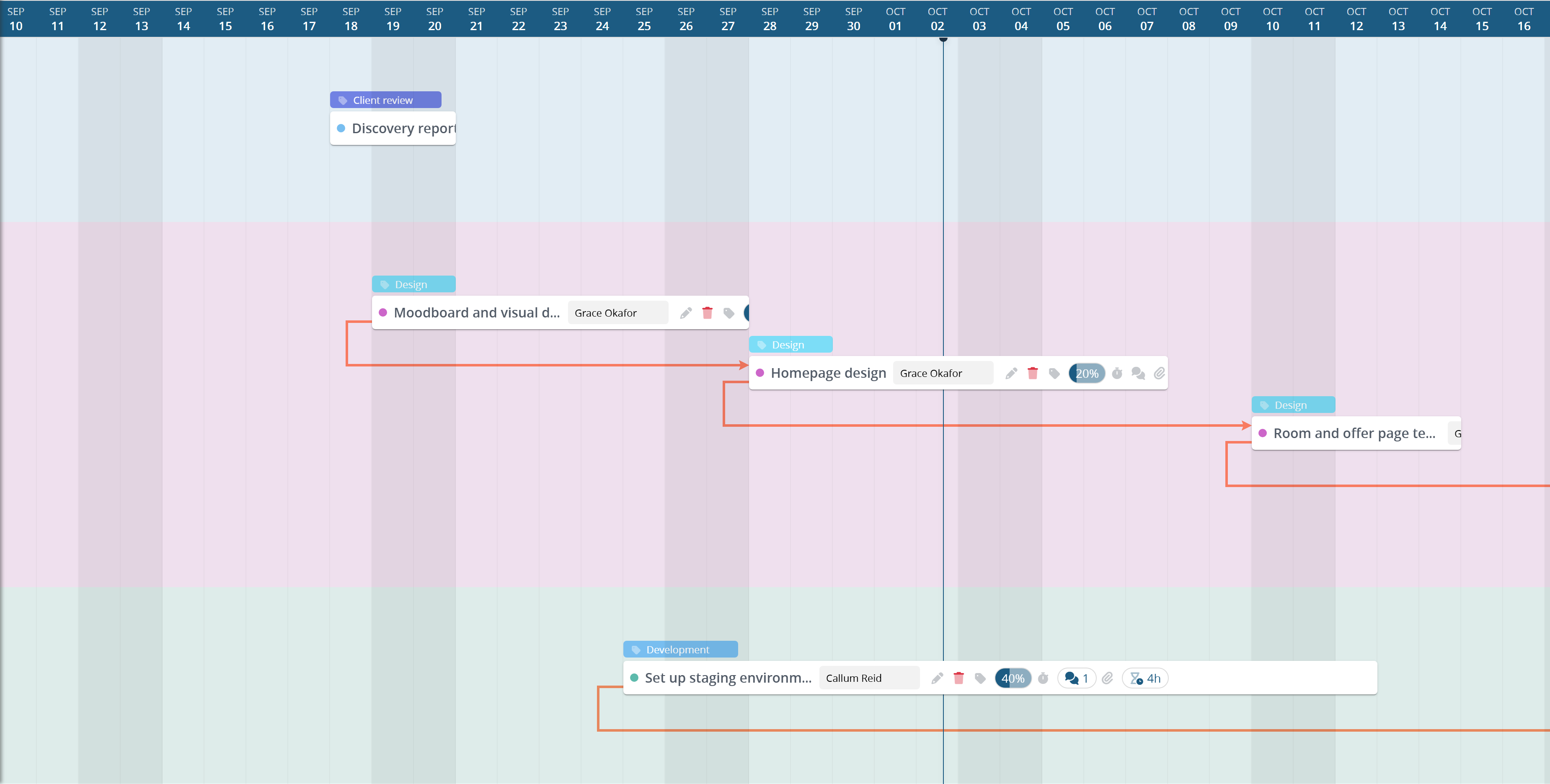

The project timeline: task lists and their tasks against a calendar

The dates run from the Monday before the project's start date, or before its earliest task, to a week after the latest of the project's due date, today and its last task. They cover at least eight weeks. Weekends are shaded, and a vertical line marks today.

Zooming and scrolling

Control What it does
Wide Shows about two months across a laptop screen
Close Shows each day, with its name and date
The zoom slider Zooms anywhere between the whole project across the screen and Close
Ctrl + scroll Zooms in and out around the pointer

The zoom you choose is remembered in your browser. Drag an empty part of the chart to scroll it in any direction.

Task lists and tasks

Each task list is a row in its own colour, with a thin bar from its first task's start to its last task's due date. The arrow next to its name hides or shows its tasks. List options next to the name holds Add Task, Edit and Delete.

Each task row shows:

  • the grip, for dragging the task to a new place
  • the task's colour and name. Click the name to open the task panel. A subtask sits under its parent
  • the number of subtasks that are not complete, when there are any
  • the task's actions, when you point at the row
  • its tags. The cross on a tag removes it
  • who the task is assigned to. Click it to change the assignees

Each task is a bar from its start date to its due date, with the first assignee's name and its time estimate. Hovering over a bar shows its dates, assignees and estimate. A red edge means the task is overdue. Completed tasks are faded and cannot be moved. A task with no due date is a hatched, one-day bar on its start date.

Changing dates on the timeline

  • Drag a bar to move the task. Its start and due dates both move, and it keeps its length.
  • Drag the start of a bar to change the start date, or its end to change the due date. Dates change in whole days.
  • Drag a task with no due date, or its end, to give it dates.

A task cannot start before the project's start date. It can run past the project's due date.

Reordering tasks

Drag a task by its grip:

  • onto another task, to put it next to that task, under the same parent
  • onto a task list's name, to put it at the top of that list
  • onto Add a task, to put it at the end of that list

A task cannot be moved into its own subtasks. Tasks cannot be reordered while any filter is active.

Tasks that wait for each other

A link makes one task wait for another: it starts after the other is due.

  1. Point at a task's bar. A dot appears at its end.
  2. Drag the dot onto the task that waits for it.

The link is drawn as an arrow. Both tasks must be on the same project, and a link cannot make a loop.

When a task moves later or its due date moves later, the tasks waiting for it are moved later by just enough, keeping their length in working days, and so on down the chain. They start on the next working day after it is due, never on a weekend. Tasks are never moved earlier. An arrow turns red when the waiting task starts before it should.

Click an arrow to change the link. The editor reads "B" waits for "A".

Control What it does
Starts [n] working days after it's due The gap between the two tasks, from 0 to 60 working days. 0 starts it on the next working day. A longer gap moves the waiting task later if it needs to
Remove link Removes the link. No dates change
Save Saves the gap

An arrow with a gap shows it, such as "+2d".

Adding a task on the timeline

  1. Type the task's name in Add a task at the foot of a task list, or select Add Task in the list's List options.
  2. Press Enter.

The new task starts tomorrow and is due seven days later. Drag its bar or its ends to set its dates. If the project's tasks have required properties, the full task form opens instead.

If the project has no task lists, the timeline asks you to create one.

On a touch screen the timeline cannot be dragged: tap a task to open it.

Moving, reordering, reassigning and linking tasks can be undone. See Undoing a change.
